|
March 2008
Start date was delayed.
The site has been cleaned and leveled and materials installed.
Constructor is no working to condense the timeline to make up time and the situation/effectiveness
of this will be known by September.
|
|
|
|
|
|
April 2008
Some delays due to heavy rain in April this year.
Site borders in place, Foundations being dug.
|
|
|
|
|
|
May 2008
Progress is back at predicted speed. Foundations being poured and steel in place.
Borders for super structure being made.
|
|
|
|
|
|
June 2008
Super structure borders are done and building has commenced. Progress will look
a lot quicker now as the base work is done and actual block building takes place.
|
|
|
|
|
|
July 2008

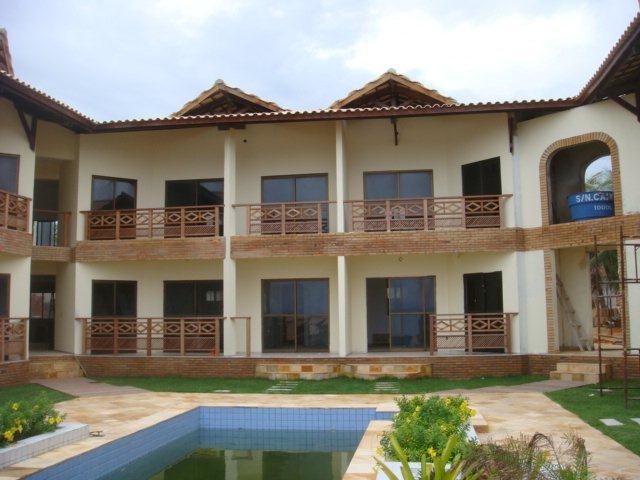

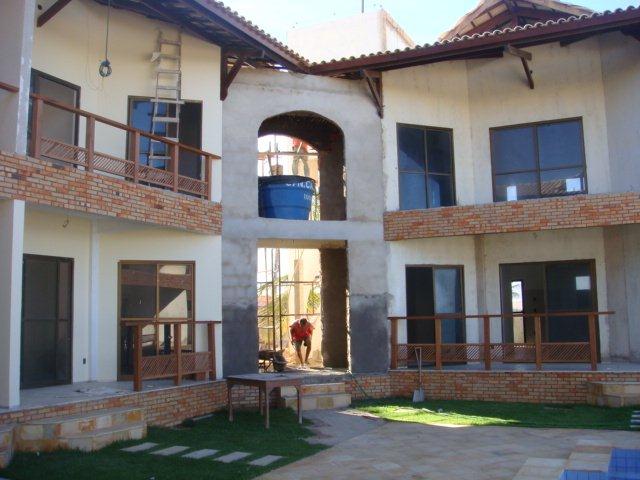

The main structure is now well under way and the first floor nearly complete.
|
|
|
|
|
|
September 2008

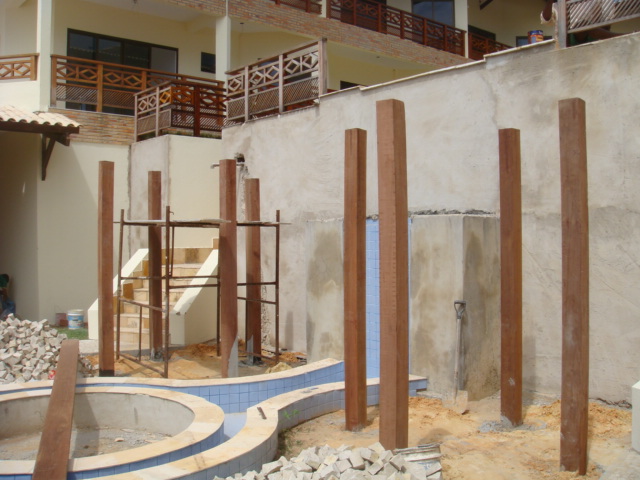

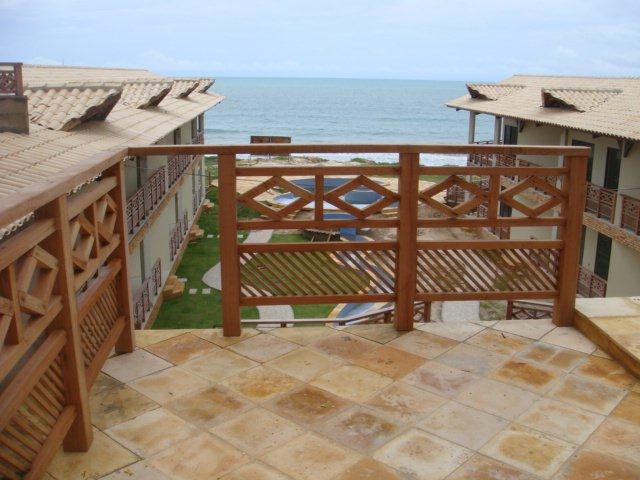

Construction going well. 2nd floor super structure is under way and central leisure areas for the pools is now being built. The waterfall and massage area is also being built now and the views from all locations of the site are fantastic. There was a lot of tourist activity this weekend with many tour busses and kites and buggies.
|
|
|
|
|
|
November 2008

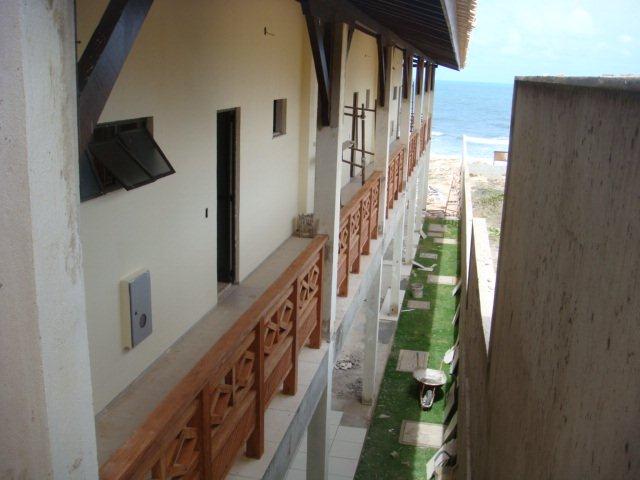

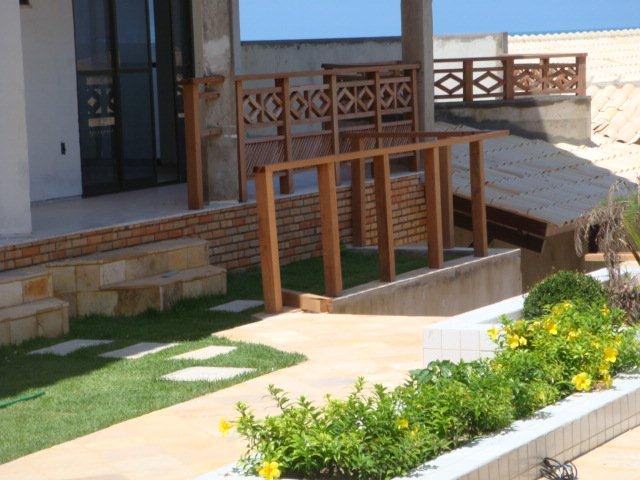

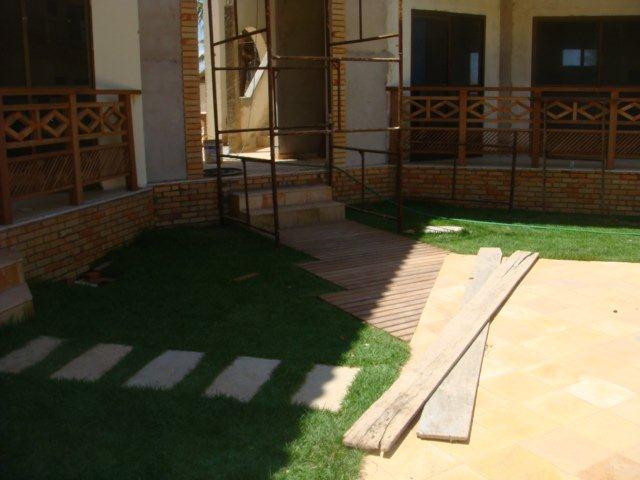

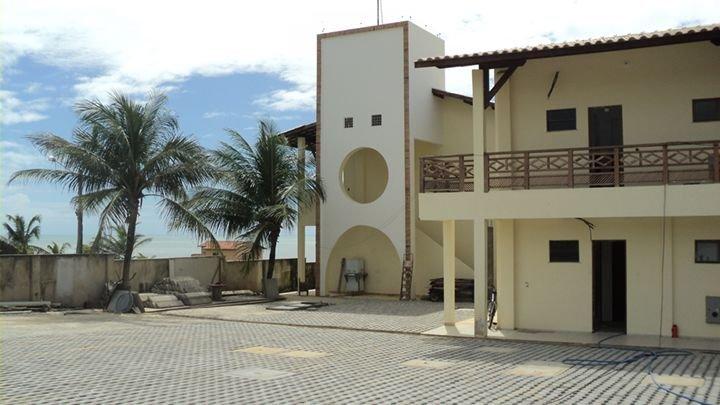

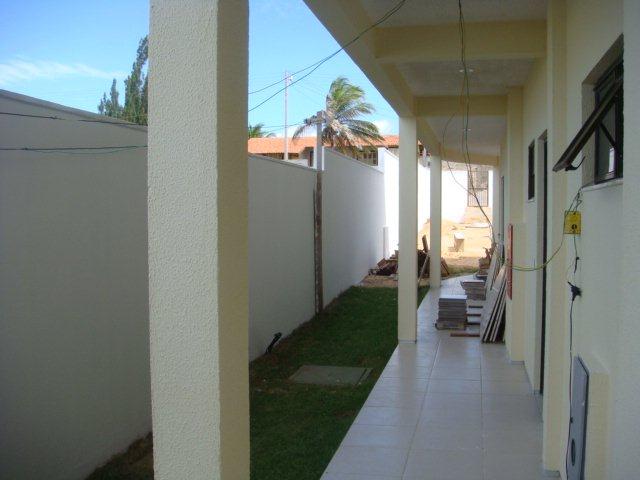

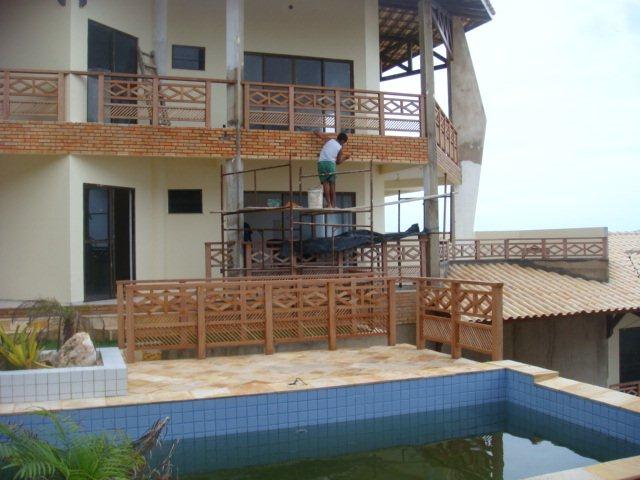

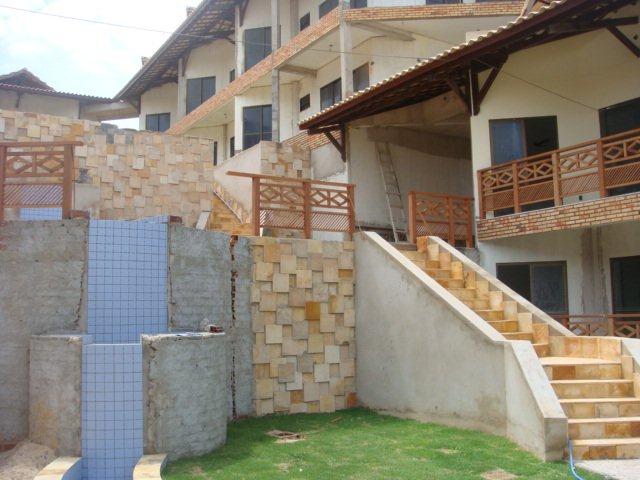

Structure is going well and plastering and roofing is under way.Internal walls are now in place and joinery will start shortly.
|
|
|
|
|
|
February 2009
Construction is progressing well again after a delay with our constructor. Issue is resolved and all proceeding well now.
We have heavy rain here this month (plus hot sun in between) so we are making some temporary drainage during the construction phase.

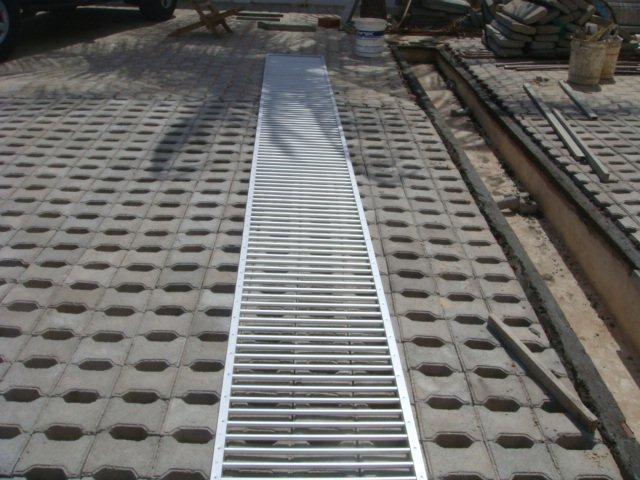

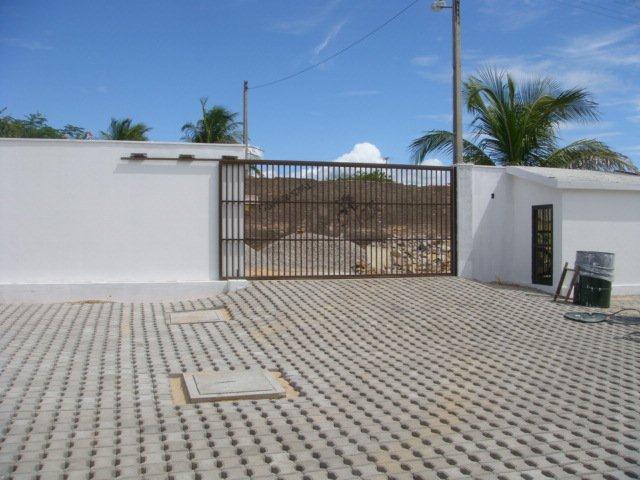

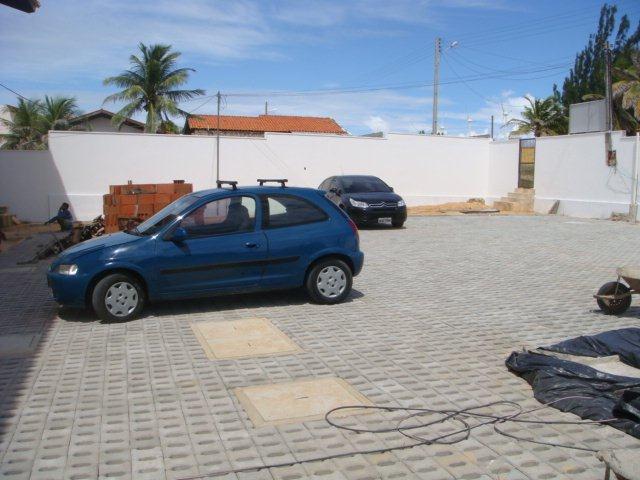

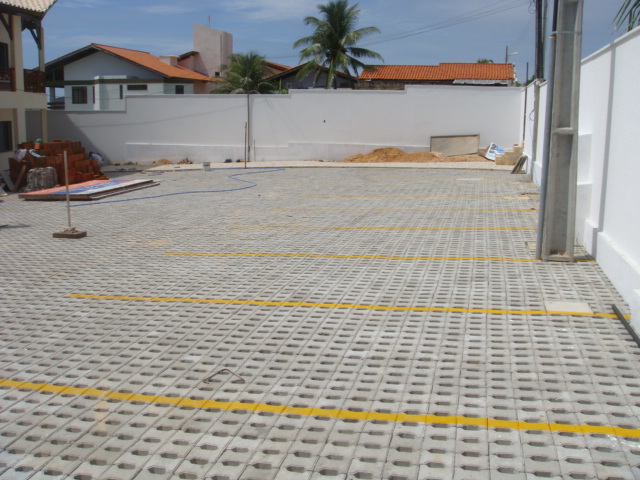

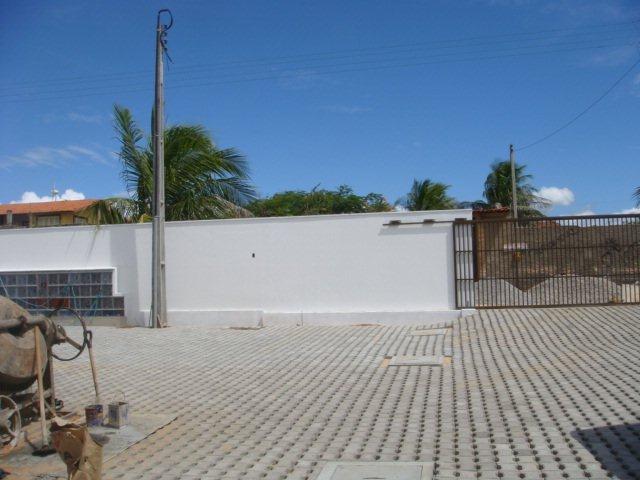

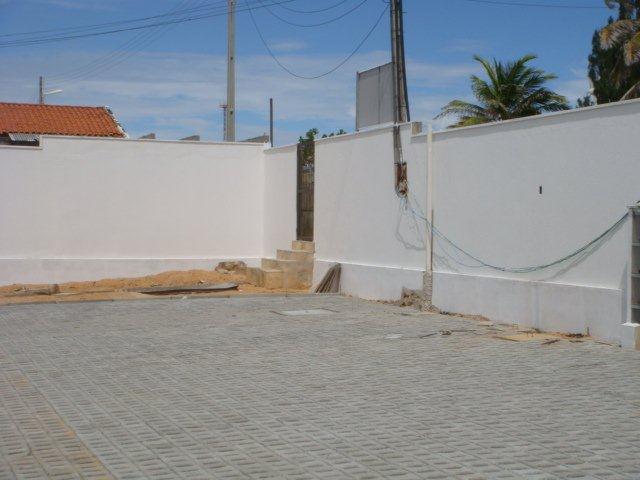

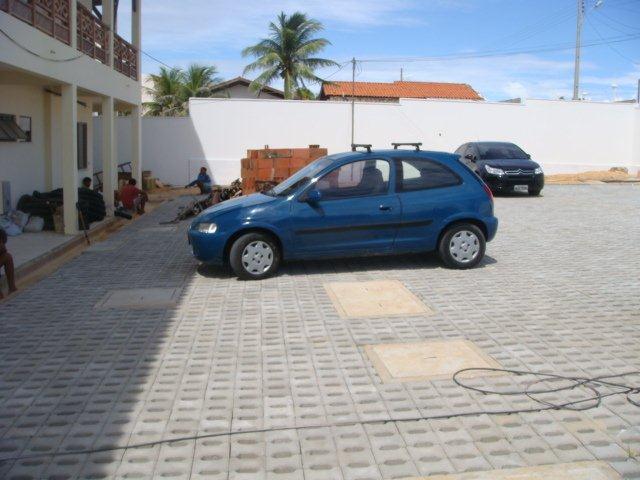

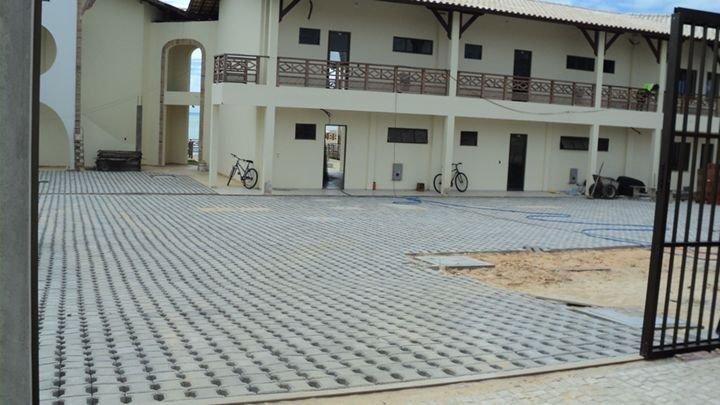

Structure is enclosed and internals are under way, the site access and parking is in construction and we are investigating making a fully furnished show apartment on site.
|
|
|
|
April 2009

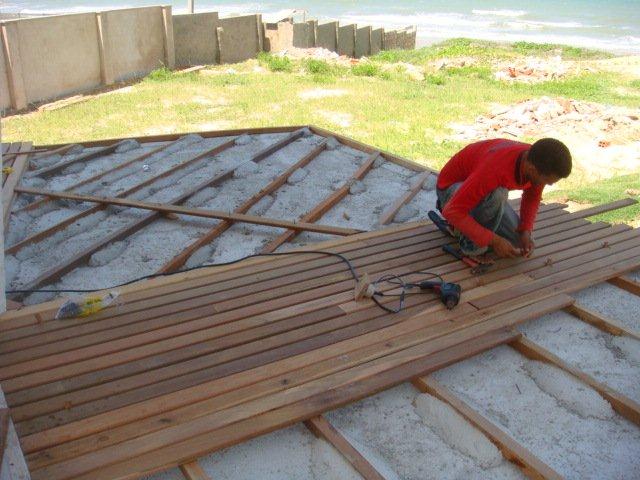

The rains are over and construction continues. The roof is now going on and as such internal work can now be accelerated.
The surrounding area is developing well with hotels and restaurants within walking distance. Photos will be uploaded mid June.
|
|
|
|
|
|
June 2009

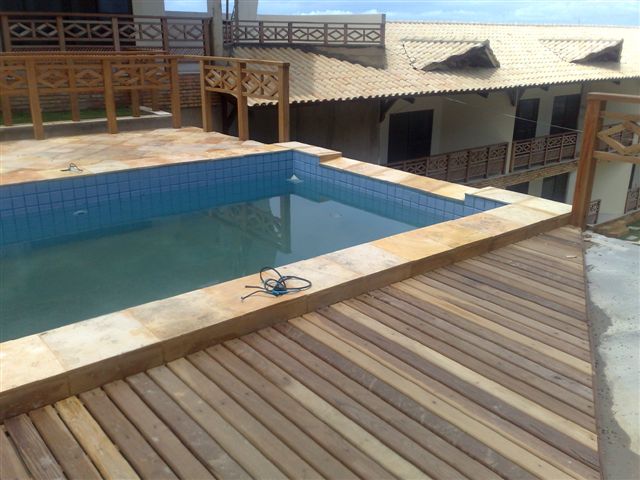

Roofing continues after delays due to heavy rains. You will see the

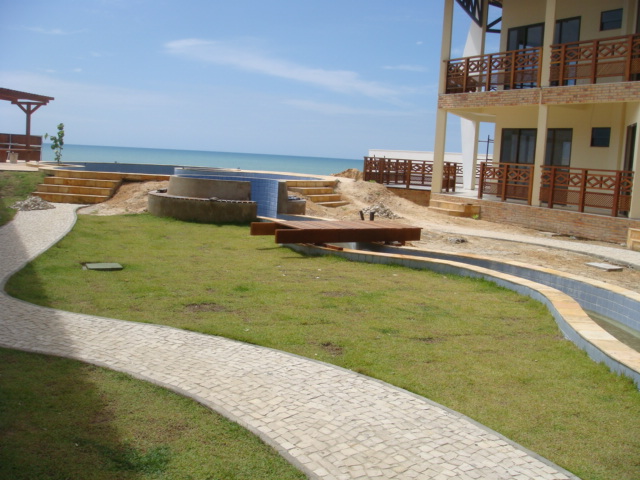

structure being enclosed now. The pools are being dug out and will be tiled
soon. We will build the rear wall and car park area shortly including the
street side gates and access. Rendering and painting will be next major
items to commence
|
|
|
|
|
|
July 2009

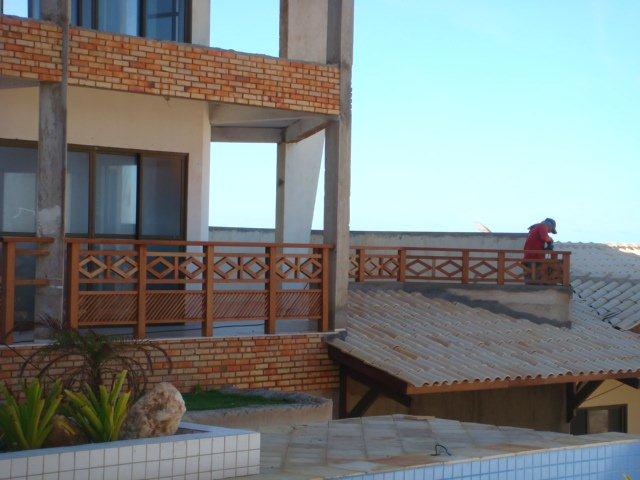

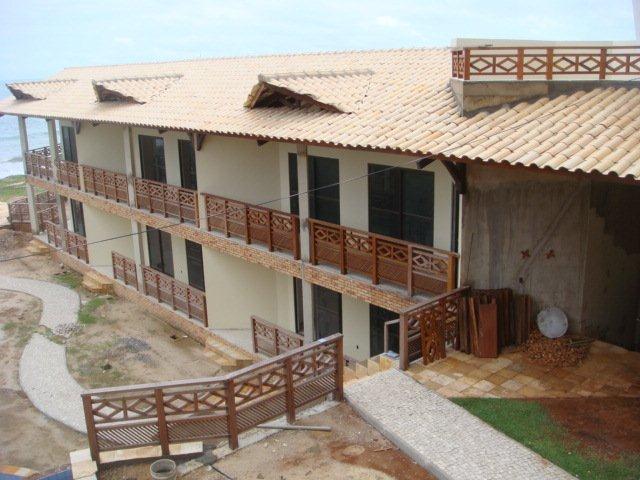

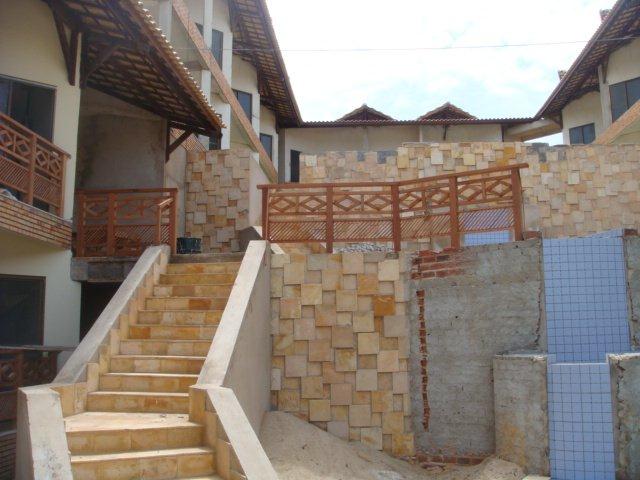

Construction of the roof is going well. Block 4 is under way now and soon
all blocks will be covered allowing plastering, joinery etc to commence.
The main retaining wall and walkway is completing that joins the upper and
lower blocks and provides the landing for the waterfall and massage/relax
areas.
|
|
|
|
|
